Documentation

gitHub

Deployment schedule



- Architecture & Design: the architecture of the solutions is super simple and described in this diagram:



Client architecture diagram



Even when leveraging the browser deployment, the security-first architecture is very simple:



Desktop and Browser architecture



- Installation: installation is super simple and takes less than 1 minute per user.

- Configuration : configuration of connections to the Git repository and databases is done in a few seconds.

- Migration of existing data models : the length of this step depends on the number of models and whether special adjustments are required.

- Acceptance Testing : customer may run testing at any time test against a list of specified requirements

- Knowledge Transfer : Hackolade provides  online user documentation, tutorials, how-to guides, and an eLearning platform with self-paced progressive video tutorials.

- Post-Implementation Support : maintenance and support are provided for as long as the subscription is valid.





🔍 Deployment Project Plan

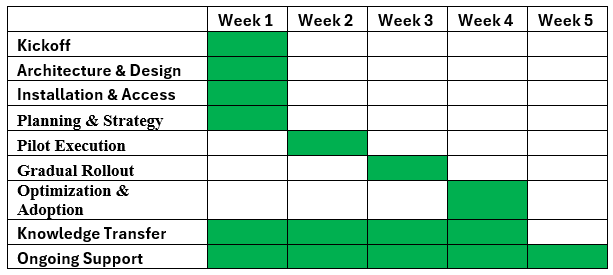

WeekActivities
Week 1Kickoff meeting, architecture & design, tool installation, environment setup, select pilot models, document objectives.
Week 2Rebuild or import models into Hackolade Studio; validate mappings from legacy data modeling tools; resolve mismatches.
Week 3Go/No-Go for full migration
Week 4Hands-on workshop with users. Review CLI automation and Git workflows,  Integrate at least one model into CI/CD pipeline.  Test reverse- and forward engineering
Week 5Wrap-up: document results, team feedback, and ongoing support.
